Exterior Building Sign Installation Prep: Access, Power, Mounting, and Site Conditions

A sign installation can be delayed by details that should have been confirmed weeks earlier. A property manager may still be reviewing the drawing.

Updated on

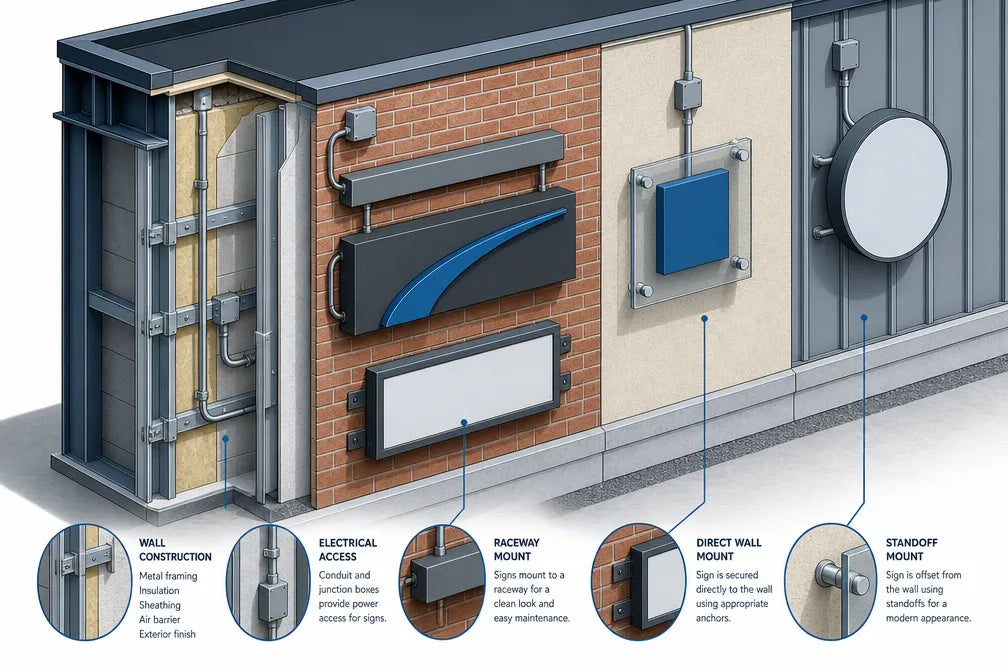

Conceptual isometric illustration showing exterior wall construction and sign mounting approaches presented as separate planning layers.

A sign installation can be delayed by details that should have been confirmed weeks earlier. A property manager may still be reviewing the drawing. Nobody may have evaluated the wall or traced the circuit. The required lift may not be able to reach the wall without blocking a busy drive lane.

The buyer and property team control much of this preparation. Fabrication happens elsewhere, and qualified parties must handle the specialized work, but those parties still need accurate information about the site before they can price and schedule the job.

Work through these questions before requesting quotes, then check them again before accepting an installation date.

What installation prep actually covers: Installation prep is not a single task owned by one person. It includes four separate workstreams, and any one of them can hold up the project.

Approvals determine whether the sign can be installed. Site information determines how the crew reaches the location and what the sign attaches to. Power determines whether an illuminated sign works once mounted. Scheduling determines how the installation affects the business, neighboring tenants, and the public.

A provider may be able to price the sign itself from artwork and dimensions. Pricing the work at the building requires site facts. When those facts are missing, the estimate depends on assumptions, and a wrong assumption can lead to a change order.

Approvals to settle before discussing dates

Two separate approval tracks usually apply, and each runs on its own schedule. The property or landlord controls one. The municipality controls the other. Neither responds to a fabrication deadline, so start both before anyone proposes an installation date.

Property and landlord approval: If you lease the space, check what your lease says about exterior changes. Do not rely on what is common at other properties. Ask which sign criteria apply, what must be submitted, who reviews it, and whether the approval covers placement and attachment as well as appearance. Find out how long that property's review normally takes.

A shopping center or managed building may also require specific insurance from anyone working on site. It may limit work to certain hours or require approved contractors for wall penetrations. Confirm those rules before the installation scope is priced.

Keep the approval in writing along with the exact drawing that was approved. A later change to the sign's size, position, or mounting may trigger another review.

Local review and permits: Requirements differ by municipality, zone, and property. A sign permitted at one address does not establish what applies at another. The first step is to assign responsibility: who determines whether review is required, prepares and files the submission, pays the fees, and responds to review comments.

Ask those same questions about electrical permits and inspections. They are often separate from the sign permit and may be handled by a different party. Also ask whether the jurisdiction requires engineered documentation for the proposed sign type, size, or mounting height, and who will prepare it if required.

Use any estimated review time only for planning. Do not release the sign for production based on an approval that has not been granted.

Document the site before anyone prices access

Access is one of the variables an installer has to price, and it is easy to overlook when a site looks straightforward from the street. Most of the information a provider needs can be recorded safely from the ground.

  • Estimate the height from grade to the bottom and top of the proposed sign area, and note how you estimated each measurement.
  • Record what is directly below the sign area, such as a sidewalk, planting bed, drive lane, parking spaces, patio seating, awning, or canopy.
  • Describe the surface where a lift would stand. Note whether it is level, paved, gravel, soft, or above a vault, basement, or underground utility.
  • Measure or estimate the clear width and height of the route from the street to the work position. Include gates, bollards, drive-through lanes, and low canopies.
  • Record overhead conditions along the approach and above the work area, including power and service lines, tree canopy, balconies, and overhangs.
  • Identify where a truck can park and unload, along with the distance from that point to the work position.
  • Note operating hours, delivery windows, and the times when the area is busiest.
  • Record any property rules for after-hours work and whether a shared property controls the parking lot or sidewalk.
  • Identify who has keys and can provide access to interior spaces, the roof, the electrical room, and any area behind the sign wall.
  • Take photographs of the wall straight on, a wider view of the building and its surroundings, the ground and approach where equipment would stage, and close ground-level views of the proposed mounting area.

When possible, photograph the site at the same time of day that the work would occur. A parking area that looks empty on Sunday morning may be the only customer access route during the week.

What not to do while gathering this information: Do not climb, use a ladder, or measure at height. Do not open an illuminated sign, remove a raceway cover, or touch energized equipment. Do not drill test holes to learn what is behind the wall finish. Do not loosen or remove an existing sign to inspect its attachment.

It is better to record a condition as unknown than to guess. Elevated access, wall investigation, and contact with energized components belong to qualified parties with the right equipment and insurance.

Mounting surface and structure

The wall affects the attachment method. That choice can change the required hardware, labor, sealing, and sometimes the sign design.

What you can record:

  • Identify the visible exterior finish, such as brick, block, poured concrete, stucco or a synthetic finish system, metal panel, wood, tile, stone veneer, or glass.
  • Note the apparent condition of that finish, including cracks, spalling, loose material, stains, earlier patches, or open joints.
  • Record whether an existing sign occupies the area, its approximate footprint, and whether old penetrations, a raceway, or a backing plate remain.
  • Mark any visible joints, control joints, panel seams, flashing, or trim that crosses the proposed sign area.
  • If known, identify what is directly inside the wall at that location, such as an office, stairwell, mechanical room, or finished tenant space.
  • Gather any building drawings, previous sign drawings, or earlier vendor paperwork that the property still has.

What a qualified party has to confirm: The visible finish is not the supporting structure. The provider, installer, and, where applicable, a qualified engineer must determine what is behind the finish, whether it can support the proposed sign's weight and wind loading, which anchors suit the construction, and how penetrations will be sealed.

Synthetic finish systems, metal panel walls, veneers, and glass or curtain wall assemblies can require specific attachment details. An unsuitable attachment may create a path for water that does not become visible until long after installation.

Ask who will evaluate the wall, whether a site visit is needed, whether that visit has a separate fee, and how the quote changes if the wall differs from the original assumption.

Power and electrical readiness: For an illuminated sign, building-side power is a separate scope that runs alongside the sign project.

Record what is safely known or visible. Was a previous sign at that location illuminated? Is its circuit believed to work? Where is the electrical panel, and does the tenant or property control it? How should the sign turn on and off? Earlier sign records held by the property may also describe what was installed.

A licensed electrician must handle everything beyond those observations. That includes confirming the source, tracing or establishing the circuit, checking available capacity, sizing and routing the supply, making and sealing the penetration, providing any required disconnect, and completing the final connection.

The sign provider supplies the electrical specification for the sign and its internal components. The building-side work and the sign specification are different scopes. If a quote mentions lighting but does not say who performs the building-side electrical work, that responsibility has not been settled.

Site conditions and the installation day

The building keeps operating while the sign goes up. Most of what makes an installation day difficult is not technical. It is the parking area that fills at eleven, the entrance that cannot close, and the neighboring tenant who was never told. Settle those points with the property before anyone proposes a date.

Weather and season set the outer limit. Wind, temperature, and precipitation can stop elevated work, so ask which conditions trigger a hold, how the installer communicates it, and how rescheduling works. Business operations set the inner limit. Identify when the work can happen without stopping normal operations, and raise those limits before anyone sets a date. Adjacent tenants sit in between. They may share parking, sidewalks, and exposure to noise, and advance notice can prevent a complaint from stopping the work.

Four further conditions are easier to list than to describe:

  • Occupants and the public: Decide how the area below the work will remain clear, who controls pedestrian routing, and whether the entrance stays open. A high-traffic frontage or shared sidewalk may require a plan agreed with the property and, in some cases, the municipality.
  • Protection: List anything that needs protection, including glass, awnings, landscaping, lighting, seating, vehicles, and finishes below the work area.
  • Existing signage: If a sign is being removed, decide who takes it down, transports it, and disposes of it. Record whether the buyer wants it returned and who repairs and refinishes the wall.
  • Delivery and receiving: Decide who receives the sign, who checks it for transit damage and when, where it will be stored, and who carries the risk while it is there.

Confirm before accepting an installation date: A date is only as firm as the items sitting behind it. Before you accept one, check the short list below, and treat anything still open as a reason to hold the date as provisional rather than booked.

  • Property approval has been granted in writing and matches the current drawing.
  • Permit status is known as issued, not required, or pending, with any pending items identified.
  • The electrical scope is assigned, including who makes the final connection and schedules the inspection.
  • The required access equipment is identified, and the property has agreed to the staging position.
  • The sign has been received and inspected, with any transit damage documented.

Settle the remaining points in that same conversation rather than after a crew arrives. Confirm the site contact, the agreed work hours, and the protection plan, and get the weather and rescheduling policy written down rather than described. Agree how a site condition that differs from the quote assumption will change scope and price, since that is the moment a verbal understanding tends to fail. Then document how a deficiency is reported, including who inspects the completed sign and, for an illuminated sign, who checks it after dark.

Who normally owns each preparation task

Responsibility depends on the property, lease, jurisdiction, and each provider's written scope. Assign each item instead of assuming someone else has it covered.

Preparation item What has to be settled Party normally positioned to settle it
Property approval Which sign criteria apply, what is submitted, and what approval covers Landlord or property manager, with the tenant
Local review and permits Whether review is required, who files, who pays, who answers comments Municipality, through whoever is named as the filing party
Engineered documentation Whether it is required, who produces it, and whether the fee is inside the quote Qualified engineer, coordinated by the provider or buyer
Wall and structure evaluation What is behind the finish and whether it suits the proposed attachment Provider, installer, and engineer where applicable
Field measurement Who measures at height and who carries a refit if the sign does not fit Provider and installer
Electrical supply Source, circuit, capacity, routing, disconnect, and final connection Licensed electrician
Sign electrical specification Voltage, current draw, components, and internal wiring of the sign Sign provider and fabricator
Access equipment What equipment is required, who supplies it, and who pays for it Installer, with property permission
Traffic and pedestrian control How the area below is protected and whether a permit is needed Property, installer, and municipality
Removal and disposal Who takes the old sign down, transports it, and disposes of it Installer and provider, as assigned
Surface repair Who repairs and refinishes the wall after removal, and to what standard Assigned in the contract before work starts
Freight and receiving Who ships, who receives and inspects, who stores, and who carries transit risk Carrier, property, and installer
Site contact Who is present, who can grant access, and who can make decisions Buyer or property
Inspection Which inspections apply and who schedules and attends them Municipality, electrician, and provider
Later service How a future repair, relamp, or artwork change is requested and priced Buyer and provider

This table does not assign work to Signage.com or any other provider. It lists decisions that may need to be assigned among the parties for a particular project and address.

Be clear about what you are approving. A visual mockup can help evaluate layout, scale, placement, and visual direction. It is not a final proof, engineering drawing, permit set, structural or electrical document, fabrication file, installation plan, code document, or promise of installed appearance.

Requirements vary by property, municipality, and project scope. Use this article as planning guidance and confirm the final requirements before production or installation.

What to gather before requesting quotes

Nothing here is a prerequisite for a first conversation. Each item you can confirm, though, is one less site condition the installer has to price blind.

  • the property address and whether the sign faces a street, parking area, shared drive, or pedestrian frontage
  • photographs of the wall straight on, a wider building view, the equipment approach, and close ground-level views of the mounting area
  • the proposed sign area dimensions and approximate height above grade, with a note explaining how each was obtained
  • the visible wall finish and its apparent condition, plus anything known about what is behind it
  • details of any existing sign to be removed, including its footprint and whether it is illuminated
  • what is known about power at that location and how the new sign should be switched
  • access notes covering the staging surface, route width, overhead conditions, parking, and business hours

Three more items sit outside the site notes and are worth gathering in the same pass. Collect the lease sign criteria, property standards, previous permits, and earlier sign drawings, or note clearly that they are unavailable. Send vector artwork with fonts outlined and a named color reference for each element. Give a target timeframe as well, presented as a planning input rather than a committed date.

Reviewing building-mounted sign formats can help you put a name to the sign type and rough scale you picture on the wall you have been photographing. What it cannot tell you is how that sign attaches to your wall, whether the wall will carry it, where its power comes from, or what your property and municipality will want settled before a crew can be scheduled.

Next step: Treat the site package as the deliverable: the photographs, your estimated dimensions and heights with the method noted beside each one, the wall finish and its apparent condition, what is known about power at that location, the current approval status, and the artwork. Send it to Signage.com with the quote request for your address and describe the building as it stands today rather than as it appears in drawings. Recorded site conditions give the provider a specific job to price, and they give you a firmer basis for comparing responses and for holding a date once one is offered.

Hassan Qureshi, CEO of Signage.com

About the author

Hassan Qureshi is the CEO of Signage.com. With over 10 years of signage industry experience, he helps business owners and multi-location teams make clearer decisions around sign type, materials, lighting, visibility, mockups, and quote preparation. In 2026, he was recognized as a Top Young Sign Maker by Sign Builder Illustrated.
