Sign Engineering, Permitting, and Fabrication: Who Handles Which Step?

A sign project can stall over something other than the material choice: a required step that nobody clearly owns. Engineering, permitting, and fabrication are three separate scopes.

Updated on

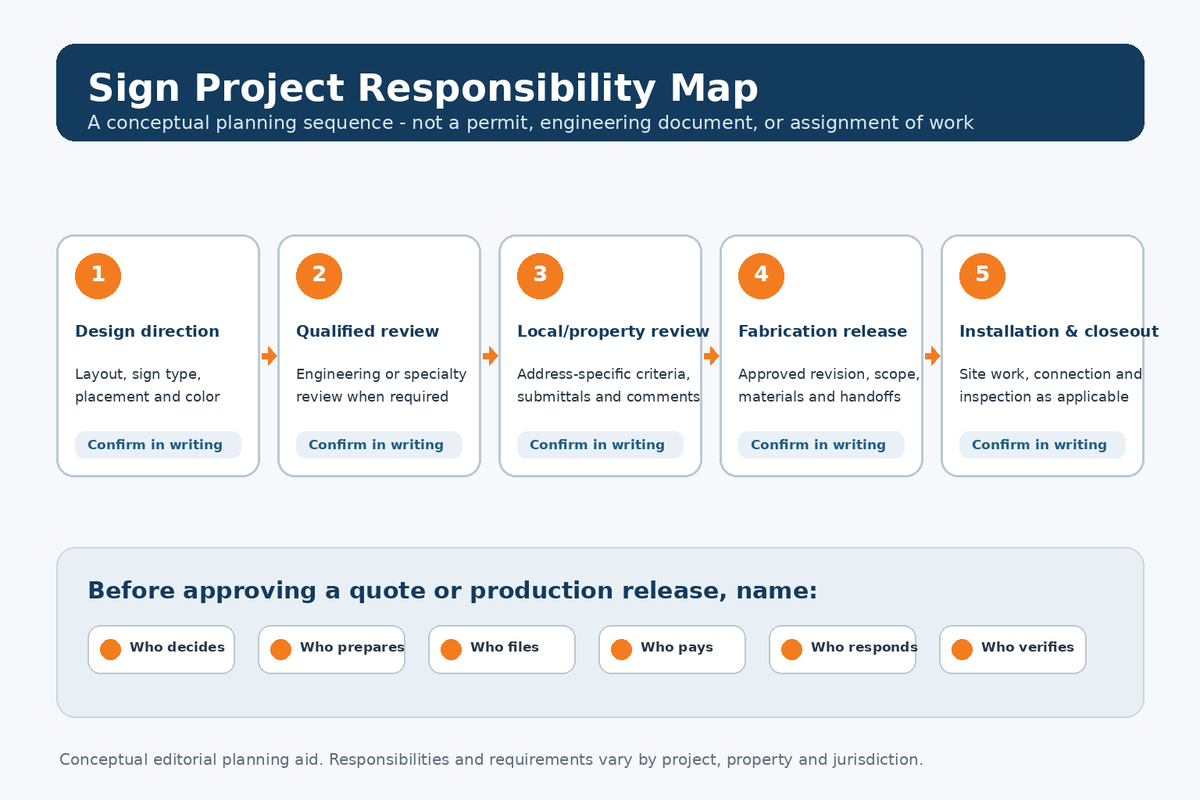

Conceptual sign project responsibility map showing design direction, qualified review, local or property review, fabrication release, and installation or closeout as separate planning stages.

A sign project can stall over something other than the material choice: a required step that nobody clearly owns. Engineering, permitting, and fabrication are three separate scopes. Each produces different documents, belongs with different qualified parties, and can fail in a different way. That is where ownership gaps hide.

One provider might carry all three scopes on one project, only one on the next, and none on another. A quote may not make the difference obvious. A broad promise to handle everything describes an intention, not a contract line.

Settle ownership while the project is still on paper. Naming the responsible party during quote review costs nothing. Finding a gap after a crate is already on a truck can cost time, money, or both.

What each step means

The labels often get used loosely in sales conversations. Separate them and the handoffs become easier to see. Five terms do most of the work, and each one names a different deliverable rather than a different phase of the same task.

Design and visual direction. Concept work settles the layout, scale, placement, sign type, and color direction. It gives you something visual to review. It is not a fabrication drawing or a permit document, and nobody should treat a concept image as either one.

Engineering. Engineering tests the concept against physical and code requirements. It addresses how the sign attaches, what the supporting structure must carry, how loading is handled at that location, and, for an illuminated sign, how the electrical design is arranged. When the jurisdiction or property requires it, a licensed engineer performs this work and supplies sealed documents. The need for engineering depends on the sign type, size, weight, mounting condition, and installation address.

Permitting. Permitting is the approval process with each party that has authority over the sign. That can include a municipality or county, along with a design review board, historic district commission, business improvement district, or landlord enforcing lease sign criteria. The process ends in an approval, a denial, or review comments that someone must answer. Requirements are local. Two addresses in the same metro area may face very different reviews.

Fabrication. Fabrication turns approved documents into the physical sign through cutting, forming, assembly, finishing, wiring, quality checks, and crating. The shop should build from the approved drawing, not from the first concept image the buyer liked.

Installation and final connection. Installation puts the sign in place. For an illuminated sign, a licensed electrician typically makes the final connection, and the jurisdiction may inspect that work. Installation is often a separate contract with its own insurance, equipment, and schedule.

Engineering: what to confirm instead of assume: An article cannot tell you whether a particular sign needs engineering. A qualified party must review the sign type, mounting condition, and local requirements.

You can still remove the uncertainty from a quote. Ask every provider to state the following in writing:

  • whether the proposed sign at the proposed size and mounting condition is expected to require engineering at this address, and who makes that determination
  • whether the work is done in house or by an outside firm, and whether that firm is licensed in the state where the sign will be installed
  • whether the engineering fee is included in the quoted total, listed separately, or excluded
  • what the engineer will deliver, such as calculations, sealed drawings, a letter, or documents formatted for a particular plan reviewer
  • what site information the engineer needs, who collects it, and who pays for the visit
  • who evaluates the wall, fascia, parapet, raceway, or foundation that will support the sign
  • who handles design revisions and resubmittal if the reviewer returns comments
  • for an illuminated sign, which parts of the electrical design belong to the sign provider and which belong to a licensed electrician

That final boundary creates more confusion than the others. The sign provider may specify the components and wiring inside the sign, while the circuit, disconnect, and final connection belong to a licensed electrician working under local electrical requirements. A line item called "electrical" may cover either scope, so the label alone is not enough.

Permitting: who files, who pays, and who answers comments

Permitting is usually the point where the calendar moves. It is also one of the easiest responsibilities to assume without assigning. The two sections below separate what a submittal package tends to contain from the questions that decide who assembles and defends it.

What a submittal commonly requires: Every jurisdiction sets its own requirements, so use this as a planning list rather than an address-specific checklist:

  • a scaled sign drawing with dimensions, materials, and mounting details
  • a site plan or elevation showing the sign's position on the building or property
  • engineering documents when the jurisdiction requires them
  • photographs of the existing condition
  • proof of property owner or landlord authorization
  • contractor license or insurance information for the installer
  • application forms and fees, which may be calculated from sign area

Several of those inputs rarely originate with the provider, even when the provider files. The buyer or property has to supply landlord authorization, lease sign criteria, recorded property restrictions, the legal business name as it should appear, and confirmation of every displayed detail. A submittal can stop over any one of them, regardless of whose name is on the application, which is why the filing question and the gathering question need separate answers.

Questions that define the permitting boundary:

  • Who decides whether this sign requires a permit at this address?
  • Who prepares and files the application, and under whose license or registration?
  • Who pays the application fees, and are they included in the quote or billed through?
  • Who responds to review comments, and how many response rounds are included?
  • How will a review-driven design change affect price and schedule?
  • Who arranges an inspection after installation when one is required?
  • If the application is denied or approved with conditions, what happens next and what has already been billed?

Nobody can guarantee permit approval or a fixed review timeline. A provider can define who files, what the price includes, and what happens if the review takes an unexpected turn. Get those commitments in writing.

Fabrication: where drawings become parts: Fabrication is the part most buyers picture when they order a sign. Once the documents are settled, it often has fewer open questions than the earlier steps. The practical risk is not an abstract concern about workmanship. It is the chance that the shop builds from the wrong reference.

Confirm which documents the shop will use and exactly what it will produce:

  • which drawing revision is released to production and who approves that release
  • the specified materials, gauges, thicknesses, and finishes for every component
  • the graphics method and a named color reference for each element, since an approved screen color is not a production reference
  • for illuminated signs, the lighting components, internal layout, and power supply locations
  • how the sign should read after dark as well as during daylight
  • which quality checks take place before crating, including whether the sign is lit and inspected in the shop
  • what the provider hands over, including as-built dimensions, component lists, and any warranty terms
  • how the sign will be crated, the expected crated dimensions and weight, and who carries transit risk

The crating answer matters sooner than many buyers expect. Crated size and weight determine the equipment needed at the receiving site. That question belongs in the site plan, not only in the shop schedule.

Who handles which step

This table does not assign work to Signage.com or any other provider. It identifies decisions that a project may need to settle and the parties commonly placed to settle them. The actual division depends on the property, lease, jurisdiction, and each provider's written scope.

Step Question to settle in writing Parties commonly involved
Existing conditions Who inspects the site and mounting location, and is that visit priced? Property, sign provider
Field measurement Who measures, including at height, and who carries a refit if dimensions were wrong? Sign provider, installer
Artwork and concept Who supplies vector files and color references, and who approves the concept? Buyer, designer, sign provider
Landlord and property approval Who submits the design, and which lease or center criteria apply? Property owner, property manager, tenant
Engineering determination Who decides whether engineering is required at this address? Municipality, engineer, sign provider
Structural engineering Who performs it, who seals it, and is the fee inside the quote? Licensed engineer
Electrical design Which part is the sign's internal wiring, and which part is building power? Sign provider, licensed electrician
Permit determination Who confirms what approvals this sign needs, and from which bodies? Municipality, sign provider, property
Permit application Who prepares and files it, and who pays the fees? Sign provider, property, buyer
Review comments Who answers them, and how many rounds are included? Filing party, engineer, sign provider
Production release Who authorizes the drawing revision that goes to the shop? Buyer, sign provider
Fabrication What is produced, and what is excluded from the shop's work? Sign provider, fabricator
Crating and freight Who crates, who ships, and who carries transit risk? Fabricator, carrier
Receiving and inspection Who receives, inspects, documents damage, and stores the sign? Property, buyer, installer
Installation Who installs, with what equipment, and what is excluded? Installer, property
Final connection Who makes the electrical connection and arranges inspection? Licensed electrician, jurisdiction
Closeout and service Who supplies documentation, and how is later service requested and priced? Sign provider, property

The order these steps need to follow

The sequence matters because assumptions become expensive once production starts.

Starting fabrication before approvals are settled is the costliest version of the problem. A reviewer may require a smaller sign, a different illumination method, or another mounting approach. Parts built to the earlier drawing may no longer be usable. Ask each provider what releases the job to production. That trigger might be your written approval, an approved permit, or a deposit, and those are not interchangeable.

Engineering usually needs real site details before it can begin. A designer may create a concept from a photograph, but an engineer cannot establish the attachment condition from one. Someone must determine what supports the sign and assess the condition of that surface or foundation.

Permitting generally requires a stable drawing. Filing while the design is still changing is more likely to create a resubmittal than a head start.

Installation scheduling depends on delivery, site readiness, and any required inspection. A firm installation date offered before those points are resolved should be treated as a planning estimate, not a commitment.

Comparing quotes on the same scope: Two quotes may both say "new storefront sign" while covering very different work. The comparison only holds if each provider labels the three scopes in this article the same way. Ask for each of the following to be marked included, excluded, or handled under a separate contract:

  • the engineering determination, who performs it, and whether sealed documents sit inside the quoted total
  • the permit work end to end, from deciding which approvals apply through answering review comments
  • landlord or property submission, which runs as an approval track of its own
  • fabrication, finishes, illumination components, and the shop inspection before crating
  • the handoffs on either side of those three scopes, meaning the site visit and field measurement before them and the crating, freight, receiving, installation, and final electrical connection after
  • what the written warranty covers and which assumptions the total rests on

Read the exclusions before comparing totals. One quote may appear lower simply because its scope ends sooner. A blank responsibility boundary usually becomes the buyer's responsibility.

What to gather before requesting a quote

A first call does not require any of this. What each item does is narrow the ownership question, since no provider can scope engineering or permitting without knowing the address, the mounting condition, and what the property already requires.

  • the property address and whether the business owns or leases the space
  • straight-on photographs of the mounting location, plus a wider view of the building and its surroundings
  • approximate dimensions of the available sign area and a note explaining how they were measured
  • the known mounting condition, such as a wall, fascia, parapet, raceway, canopy, or freestanding location
  • whether the sign will be illuminated and what is known about power at that location
  • lease sign criteria, property sign standards, and any recorded restrictions
  • prior sign drawings, permits, or vendor invoices for the location, or a clear note that none are available
  • vector artwork with outlined fonts and a named color reference for every element
  • the legal business name and all displayed details, checked against a source the tenant verifies
  • site access information, including drive access, parking, overhead conditions, pedestrian traffic, and business hours
  • a target timeframe presented as a planning input rather than a promised date

Reviewing exterior sign construction types can help you put a name to the sign you are describing, which makes the ownership questions easier to ask of each provider. It cannot tell you whether that sign needs an engineer at your address, what the jurisdiction will review, or whose license the permit application goes in under.

Before approving production

Approval turns a concept into a commitment, so make sure you know exactly what you are approving.

Check the legal business name, spelling, phone number, suite number, and every other displayed detail against a source the tenant confirms. Compare the drawing dimensions with the dimensions in the quote. Confirm each color against the agreed reference rather than how it appears on a screen. For an illuminated sign, get the expected nighttime appearance in writing.

Also confirm the document type. The Signage.com Design Studio can create a realistic preliminary sign mockup for exploring layout, scale, placement, and visual direction before a production quote. It is not a final proof, engineering drawing, permit set, structural or electrical document, fabrication file, installation plan, code document, or promise of installed appearance. Qualified parties produce those documents later, according to the scopes assigned to them.

Ask how changes in artwork, dimensions, site findings, engineering results, or local review would affect both price and scope. Requirements vary by property, municipality, and project, so use this article for planning and confirm the final requirements before production or installation.

Next step: Put the ownership question directly into the request. Gather the address, photographs, mounting details, artwork, lease criteria, and site access notes. Then open the scope-and-ownership quote request with Signage.com, attach those materials, and ask which parts of engineering, permitting, fabrication, freight, and installation the quote includes and excludes. A quote that answers that question can be compared on its actual scope.

Hassan Qureshi, CEO of Signage.com

About the author

Hassan Qureshi is the CEO of Signage.com. With over 10 years of signage industry experience, he helps business owners and multi-location teams make clearer decisions around sign type, materials, lighting, visibility, mockups, and quote preparation. In 2026, he was recognized as a Top Young Sign Maker by Sign Builder Illustrated.
